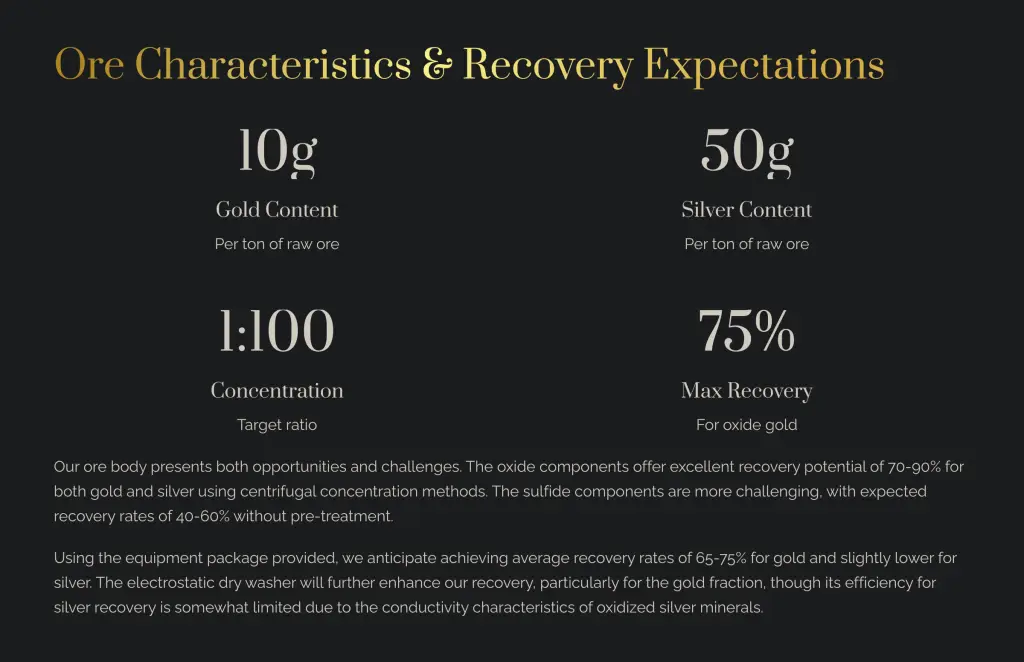

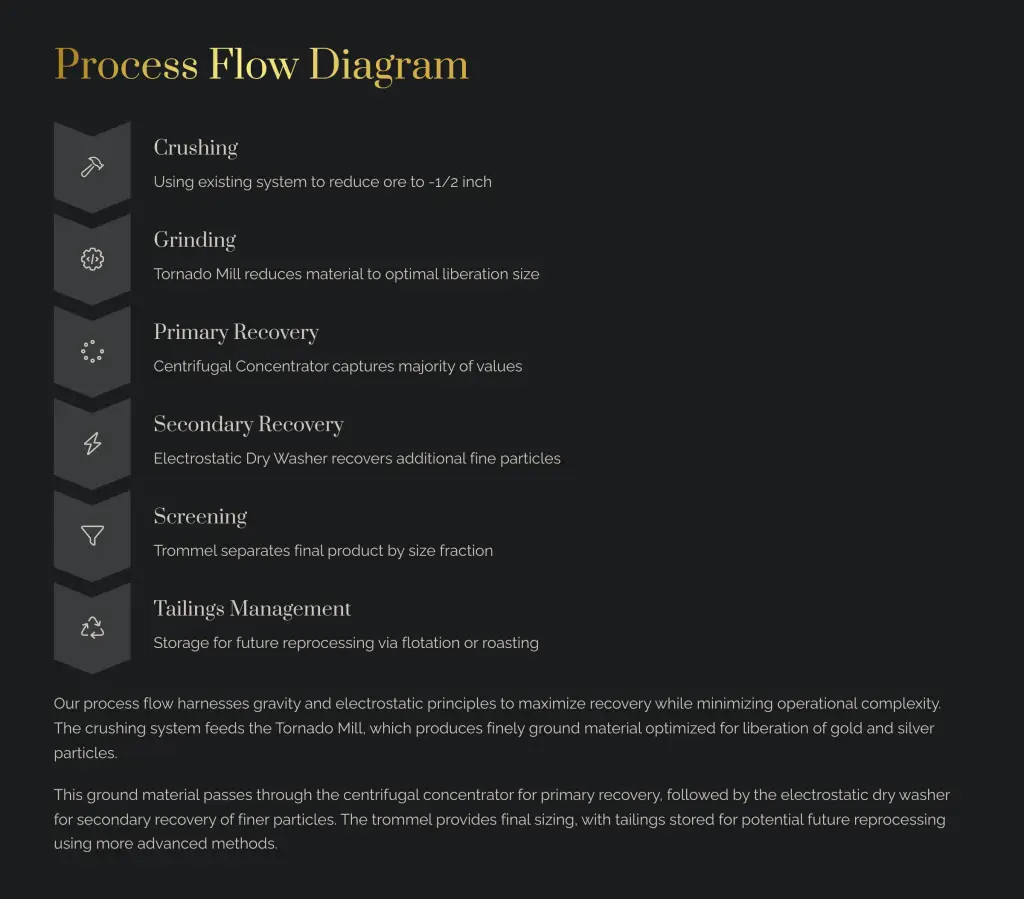

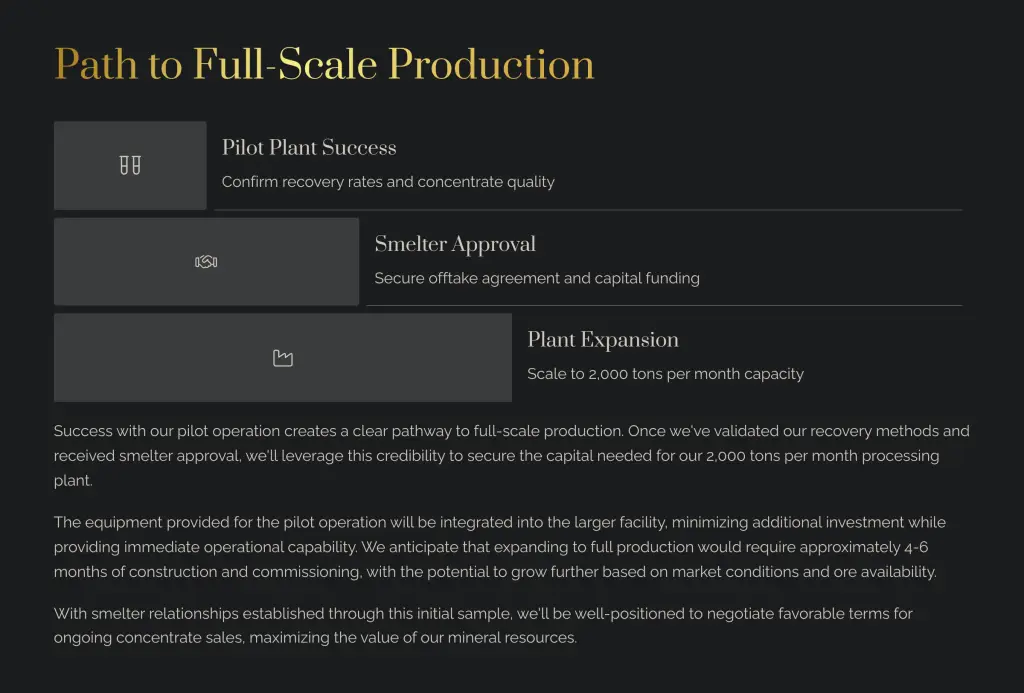

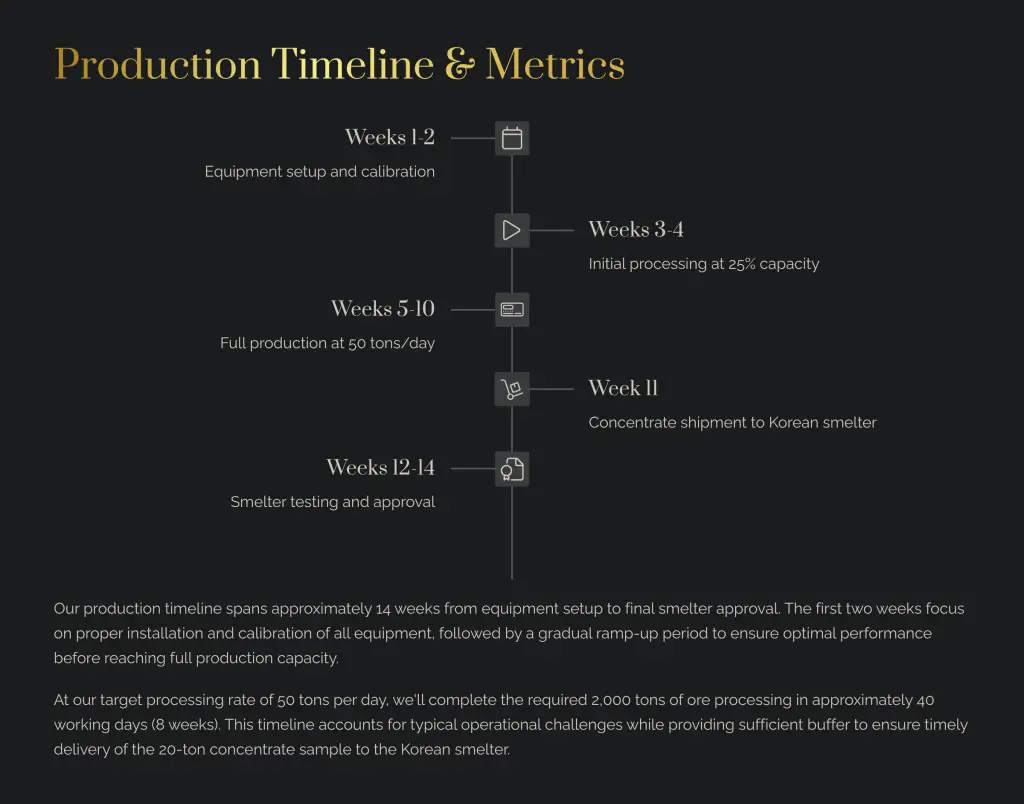

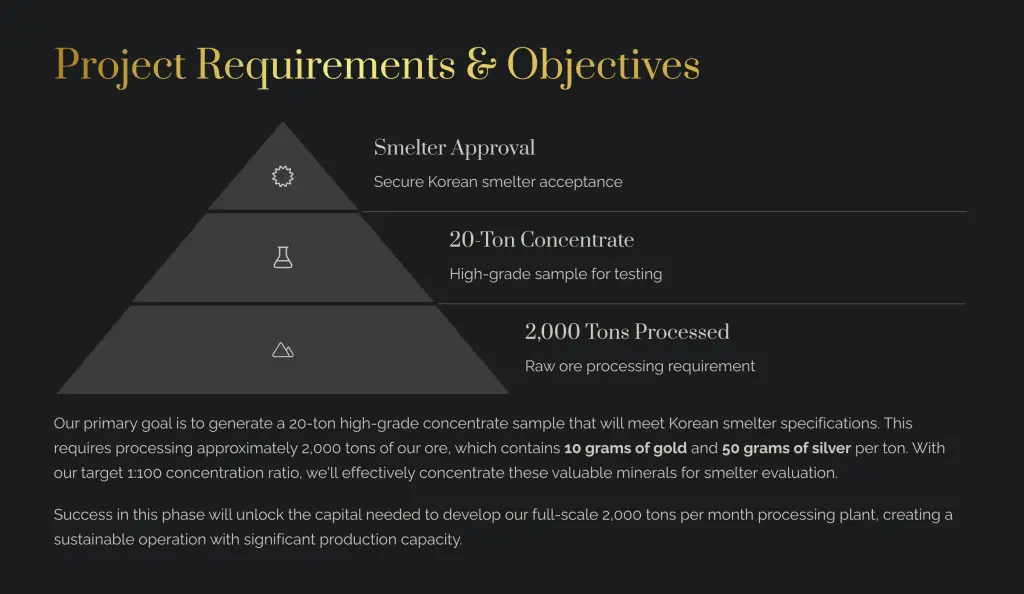

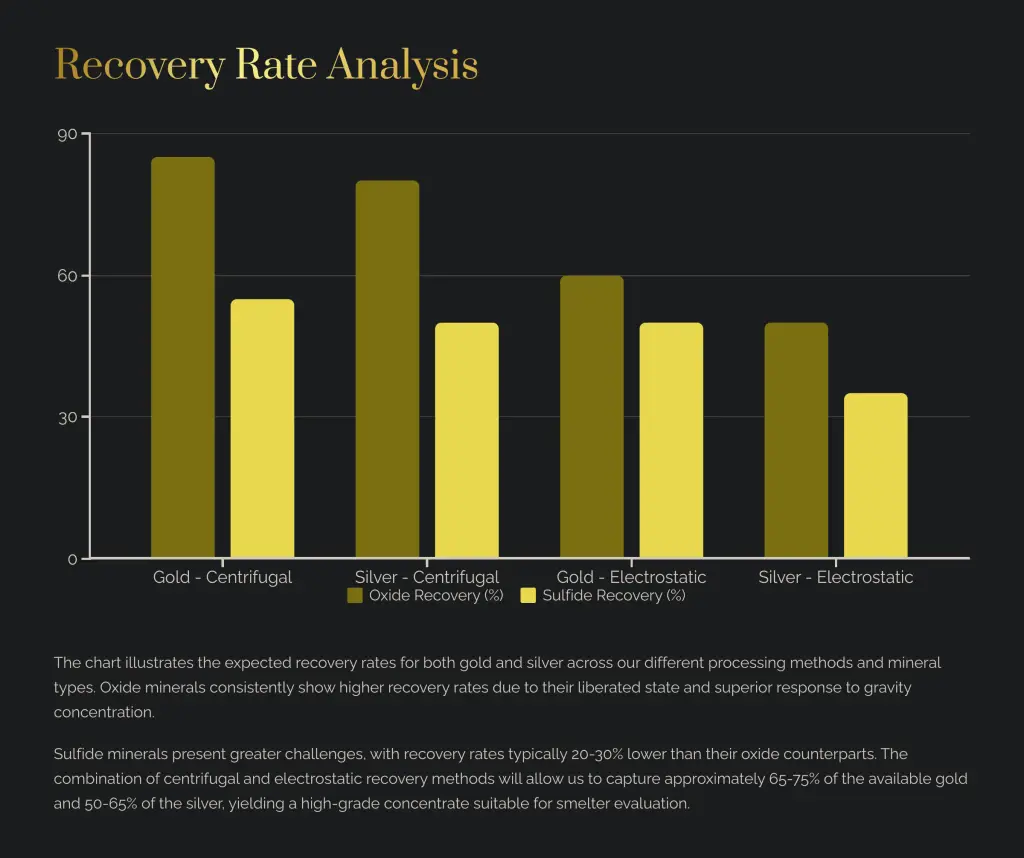

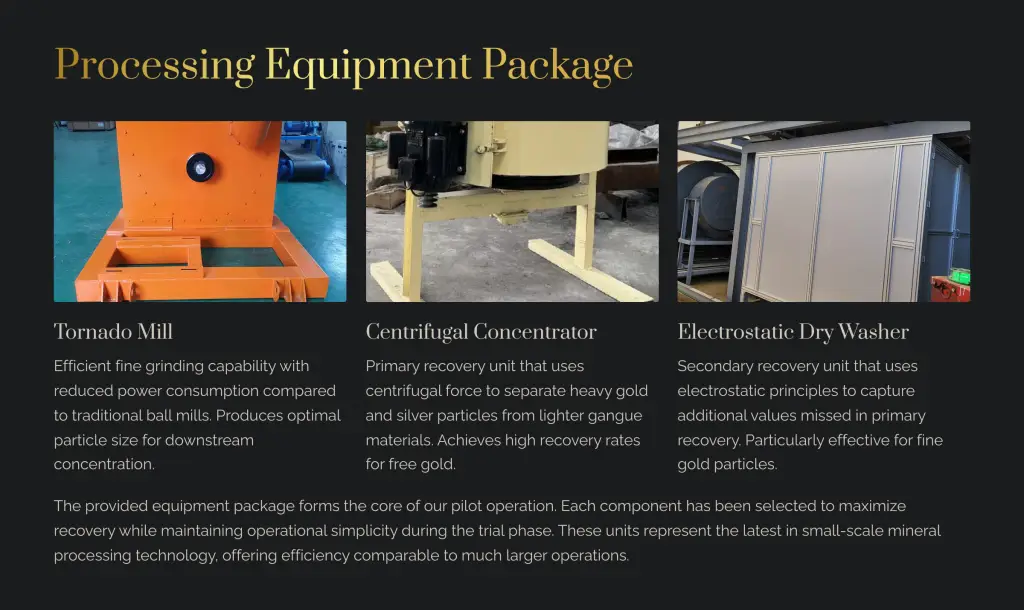

The Pilot Plant Design for Smelter Approval page outlines a plan to process 2,000 tons of gold-silver ore into a 20-ton high-grade concentrate sample for Korean smelter testing and approval. The proposed pilot plant uses crushing, Tornado Mill grinding, centrifugal concentration, electrostatic dry washer recovery, screening, and tailings storage to target about 65–75% gold recovery and 50–65% silver recovery. The project timeline is approximately 14 weeks, from equipment setup and production ramp-up to concentrate shipment and smelter approval, with the goal of supporting future expansion into a 2,000-ton-per-month processing plant.
